Hamilton
Last Updated: 6th September 2026

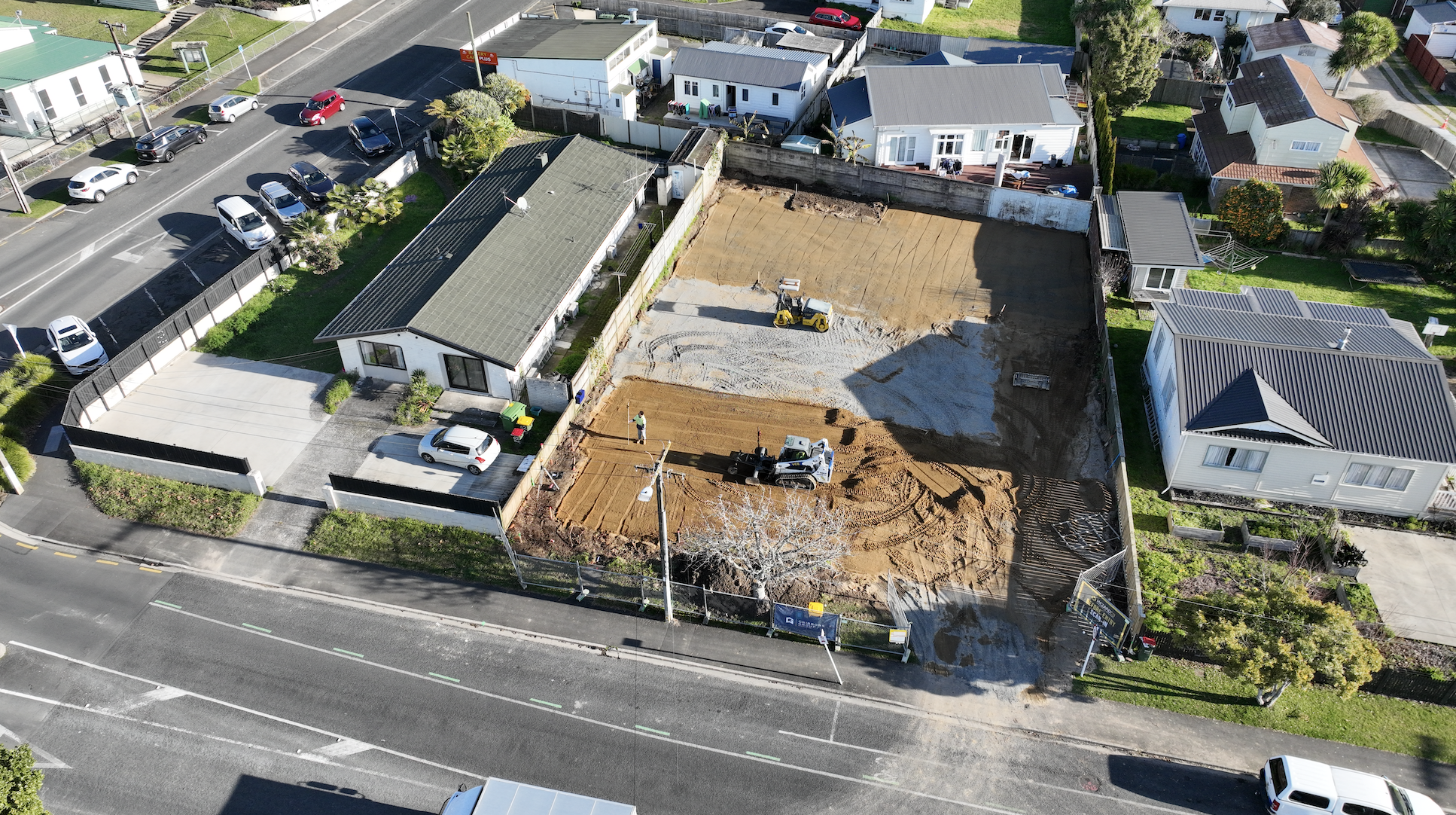

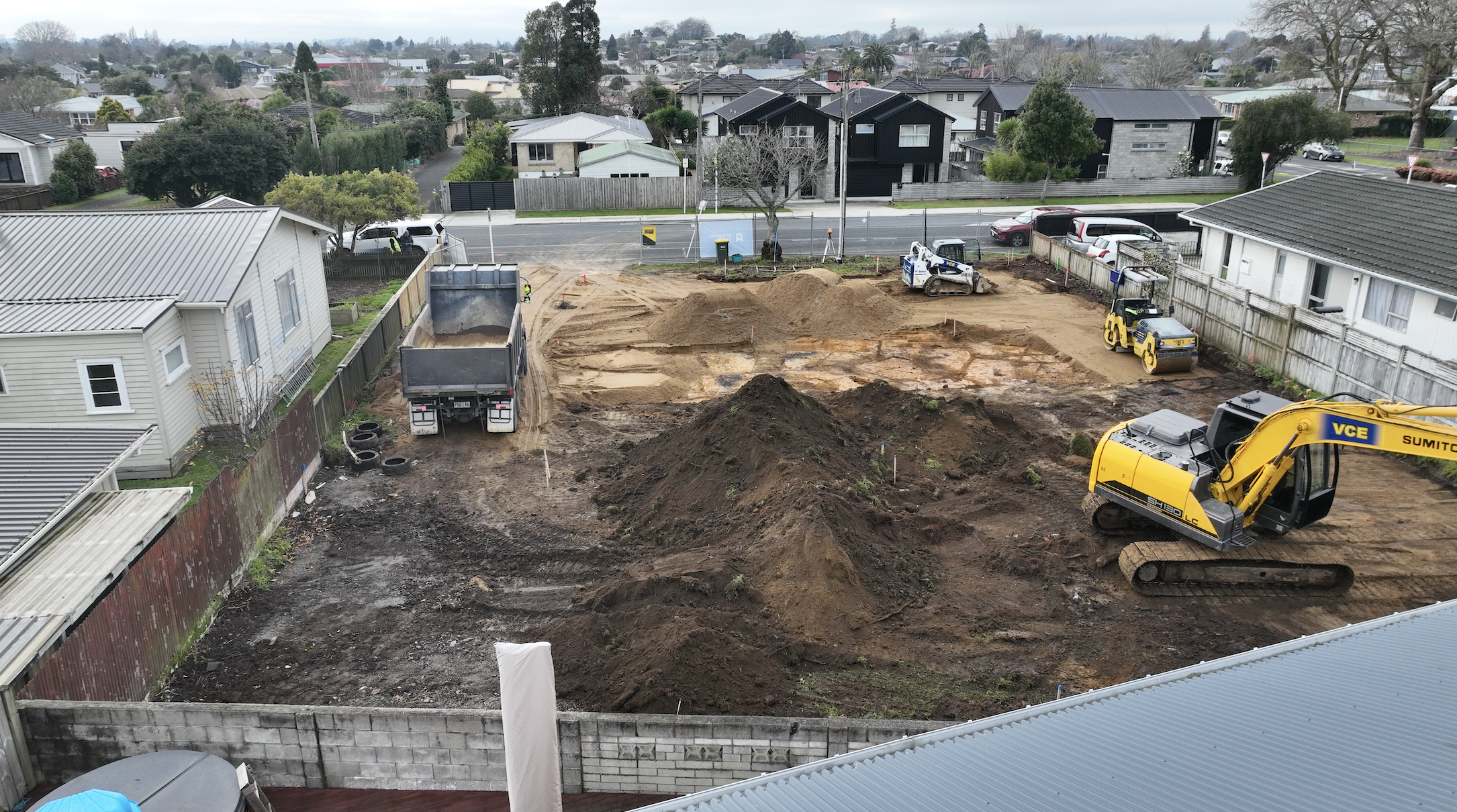

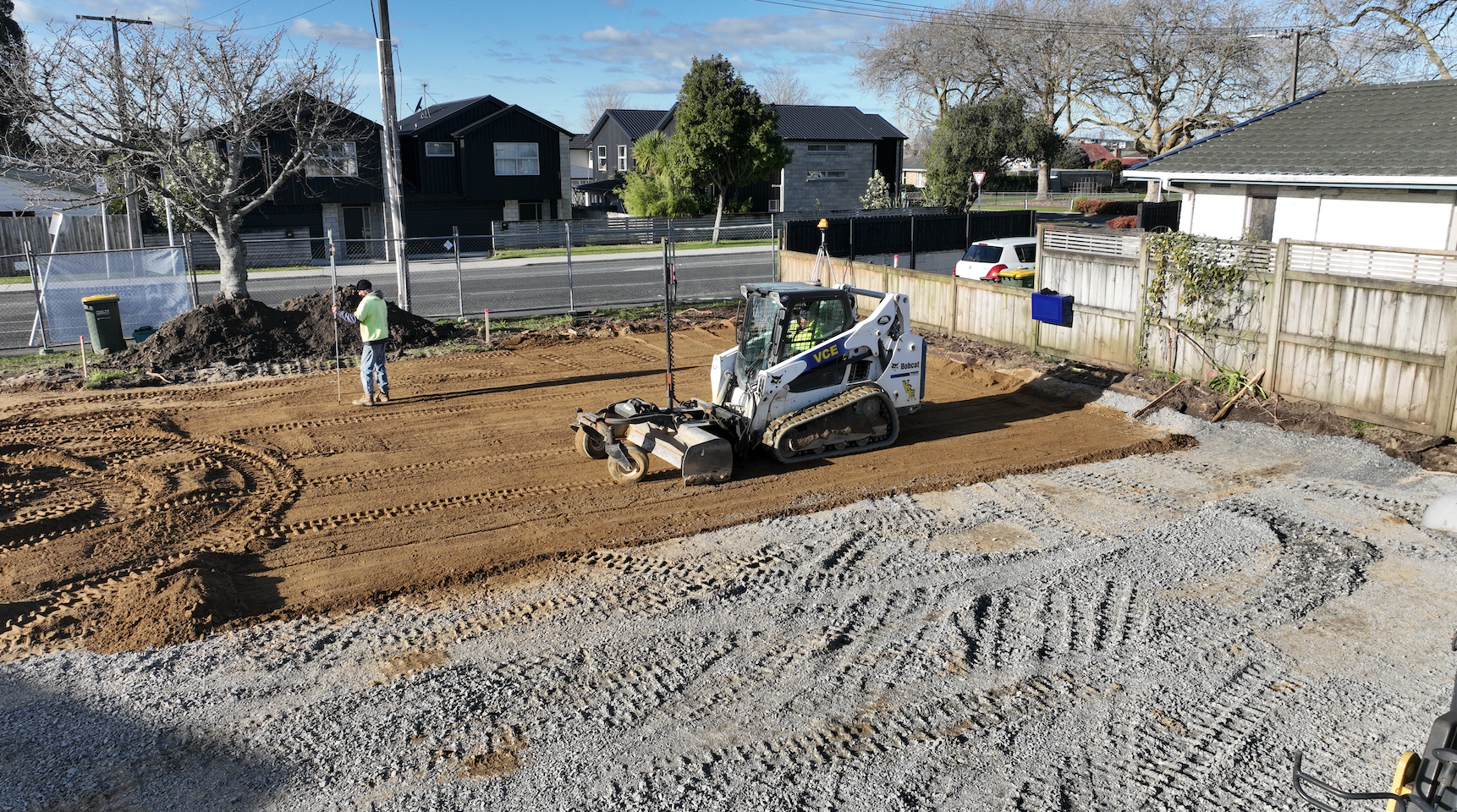

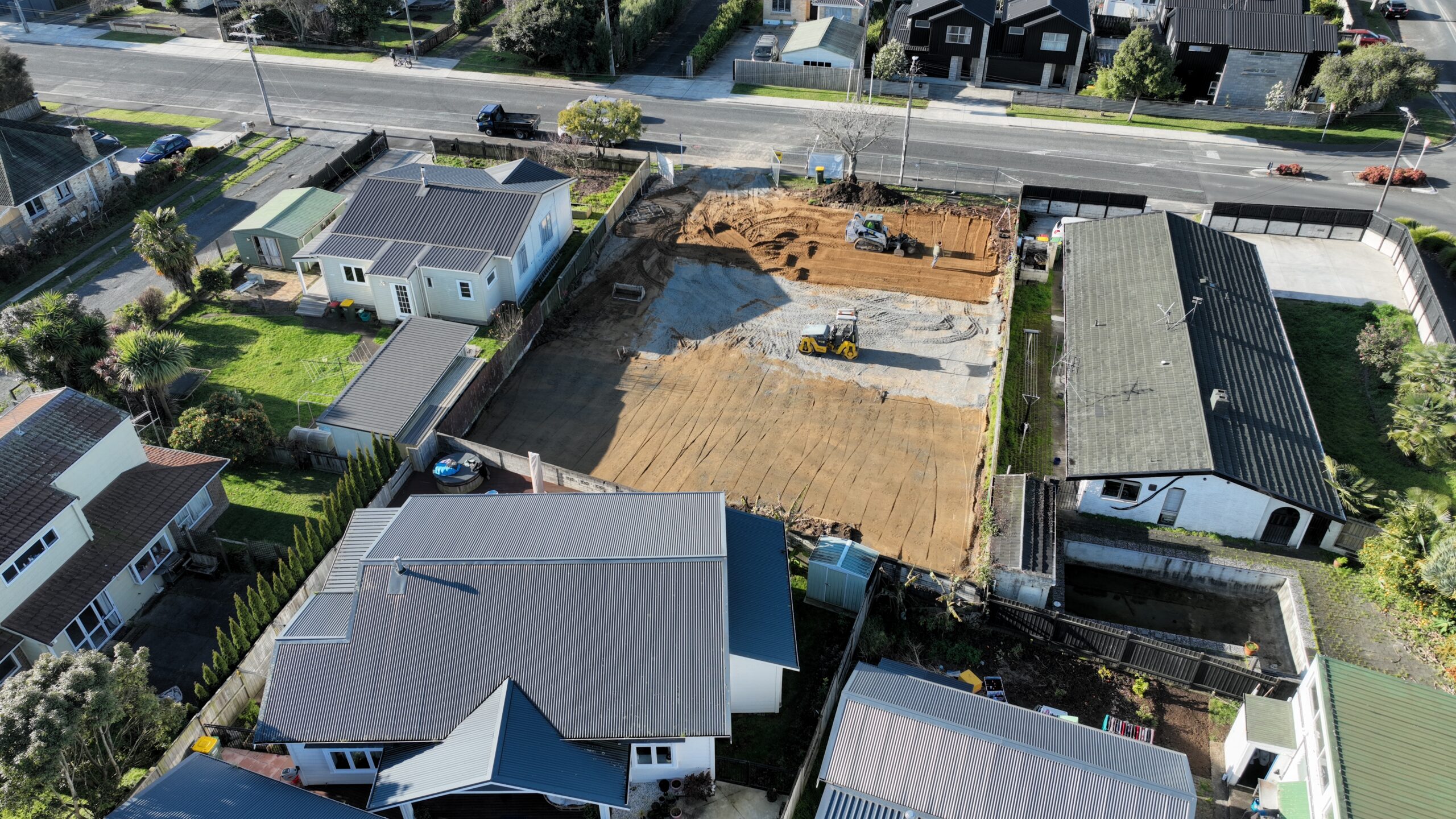

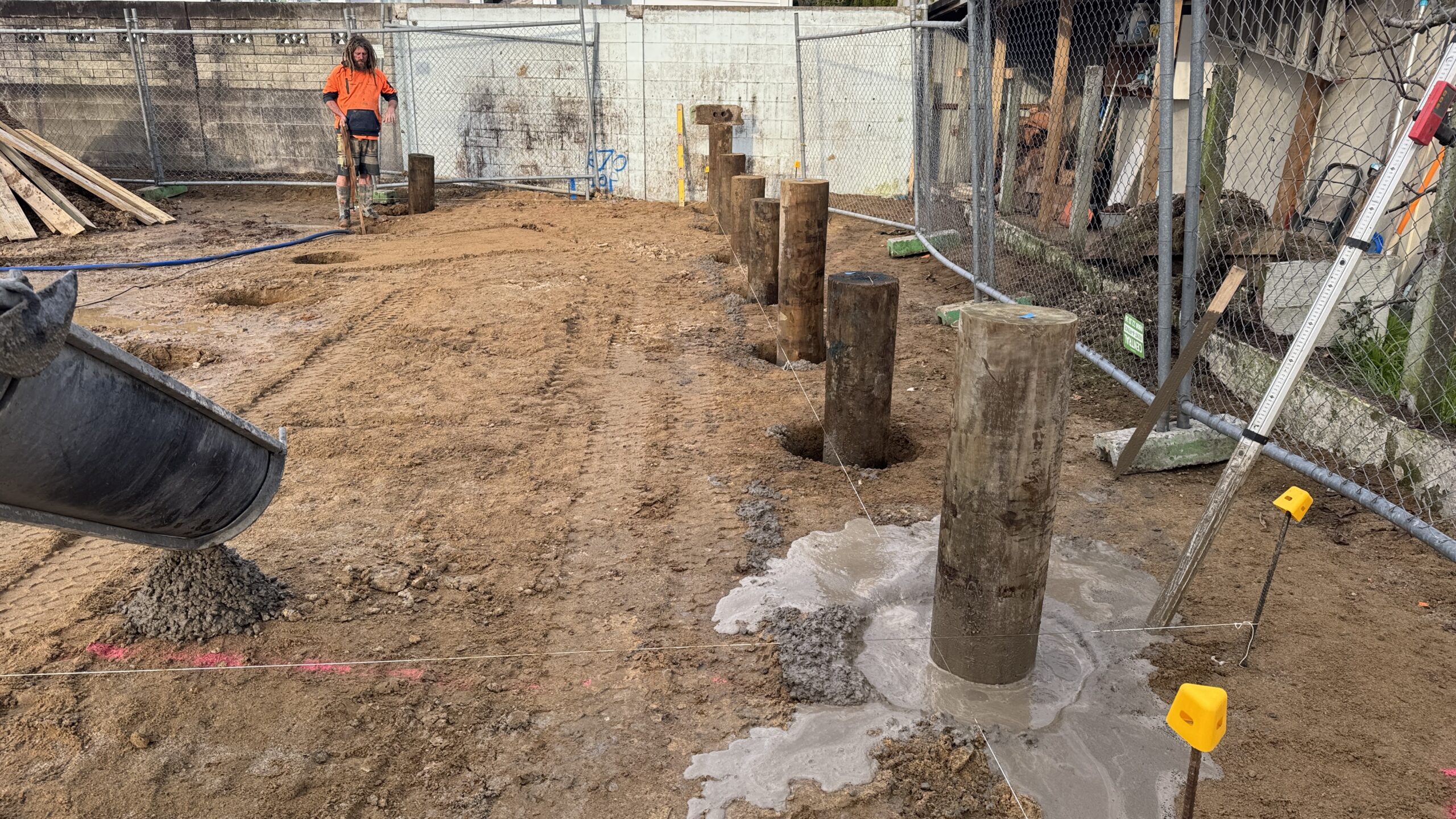

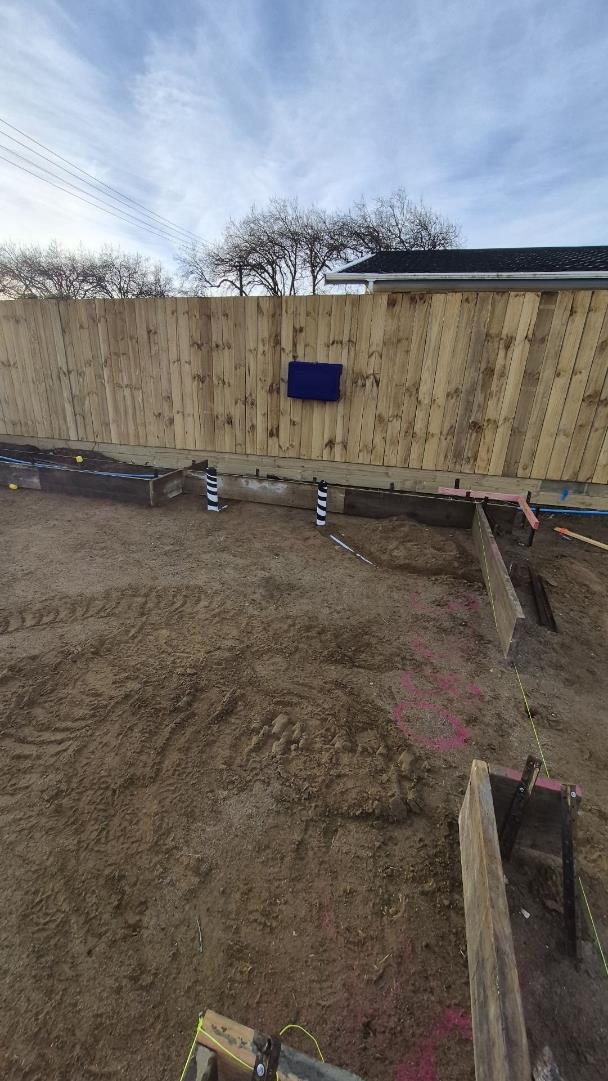

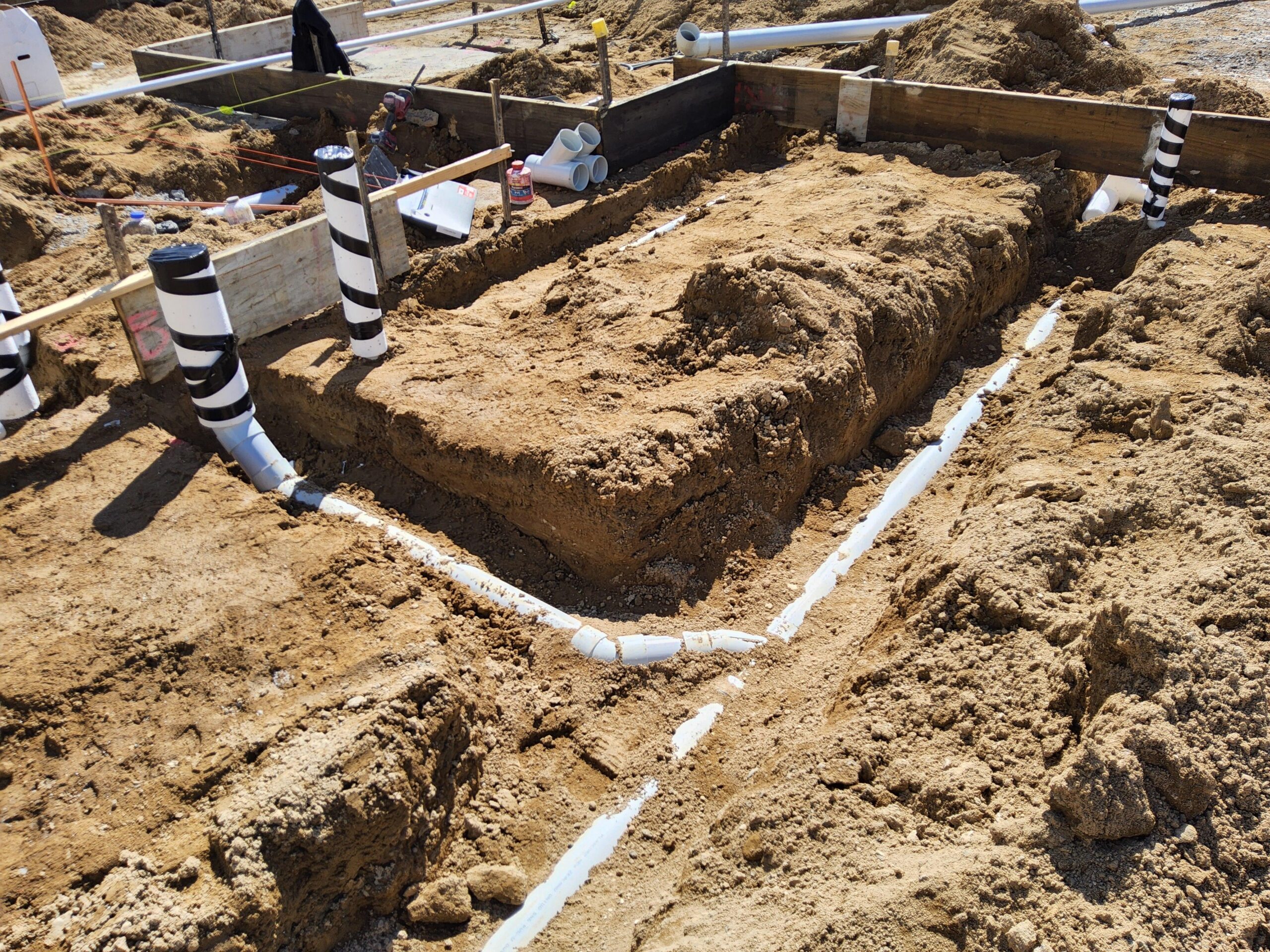

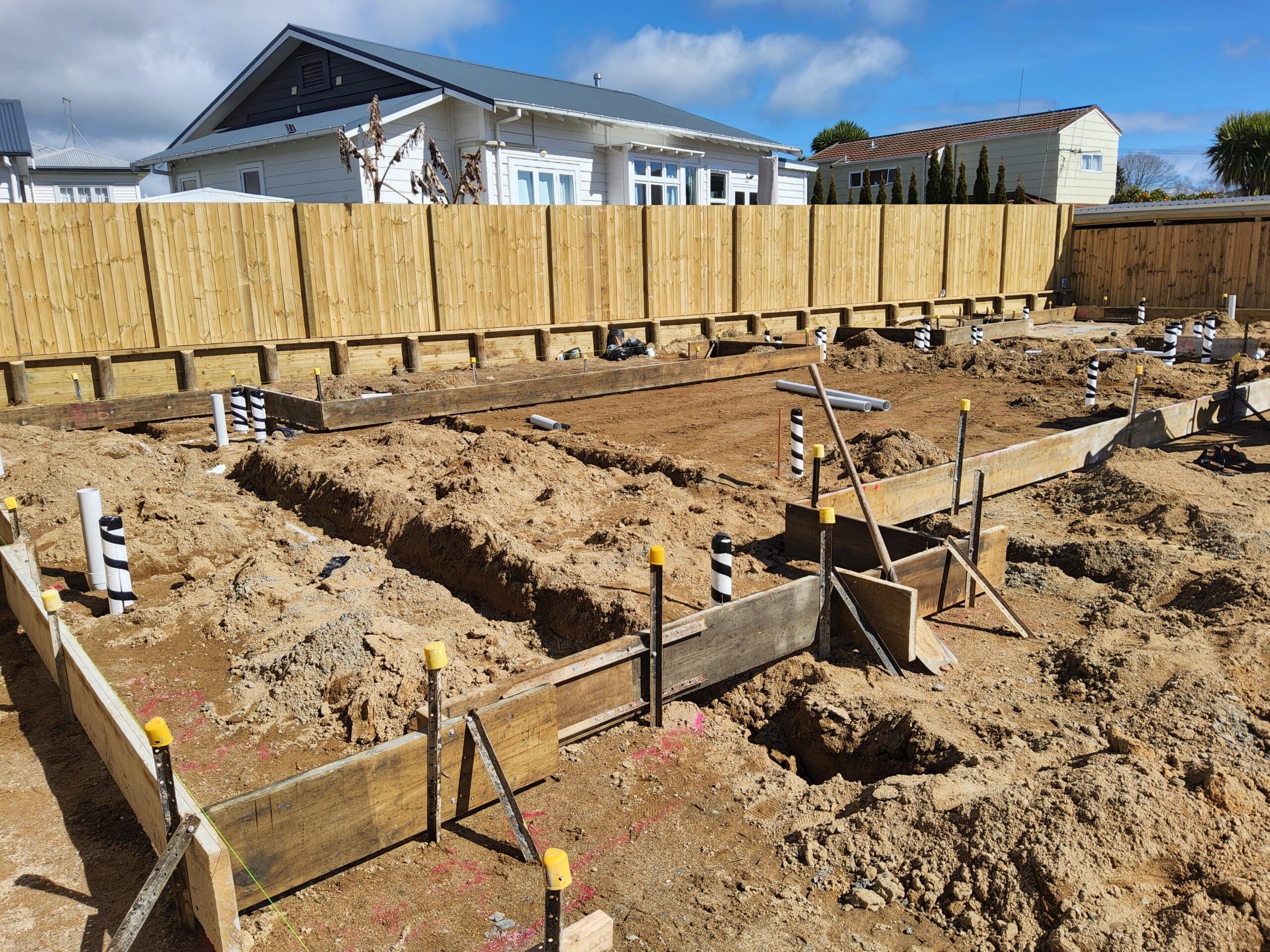

Both Block A and Block B foundations are now fully boxed, with all under-slab plumbing installed. The plumbing inspection has been successfully completed and passed. All boundary fencing and retaining works have also been completed across the site.
Over this month, the focus will be on progressing the early site works, including:

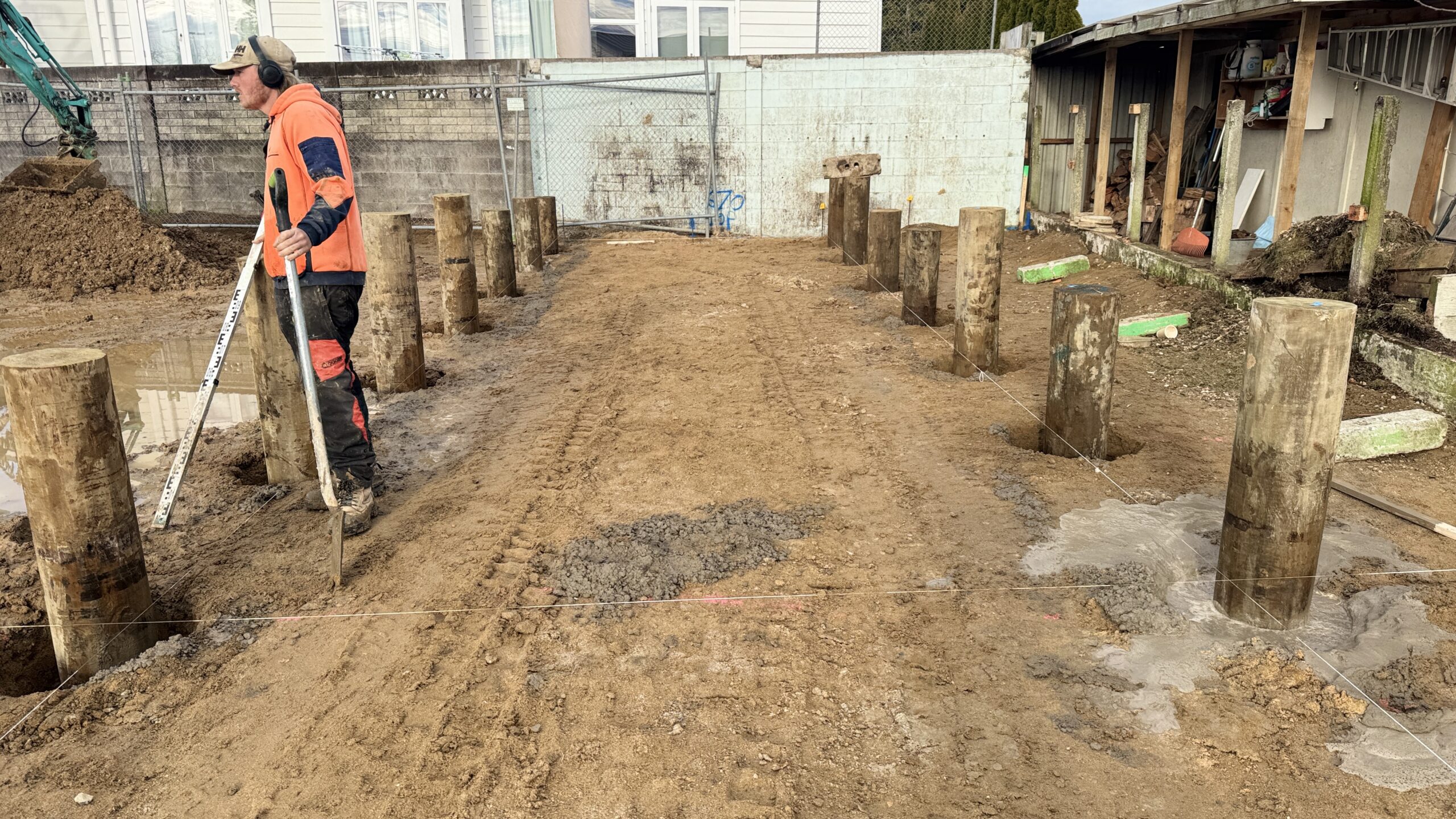

• Install reinforcing steel to both foundations

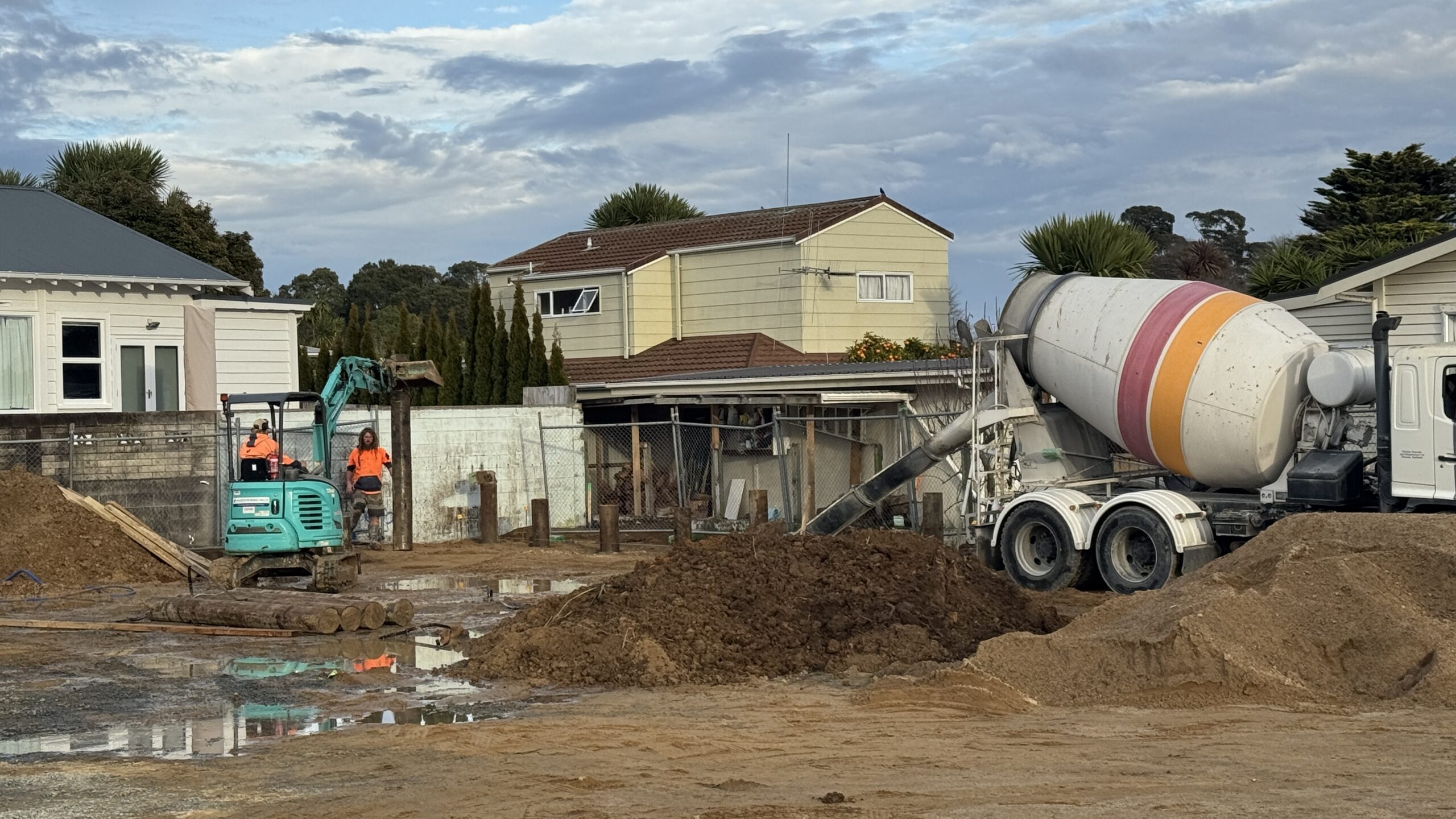

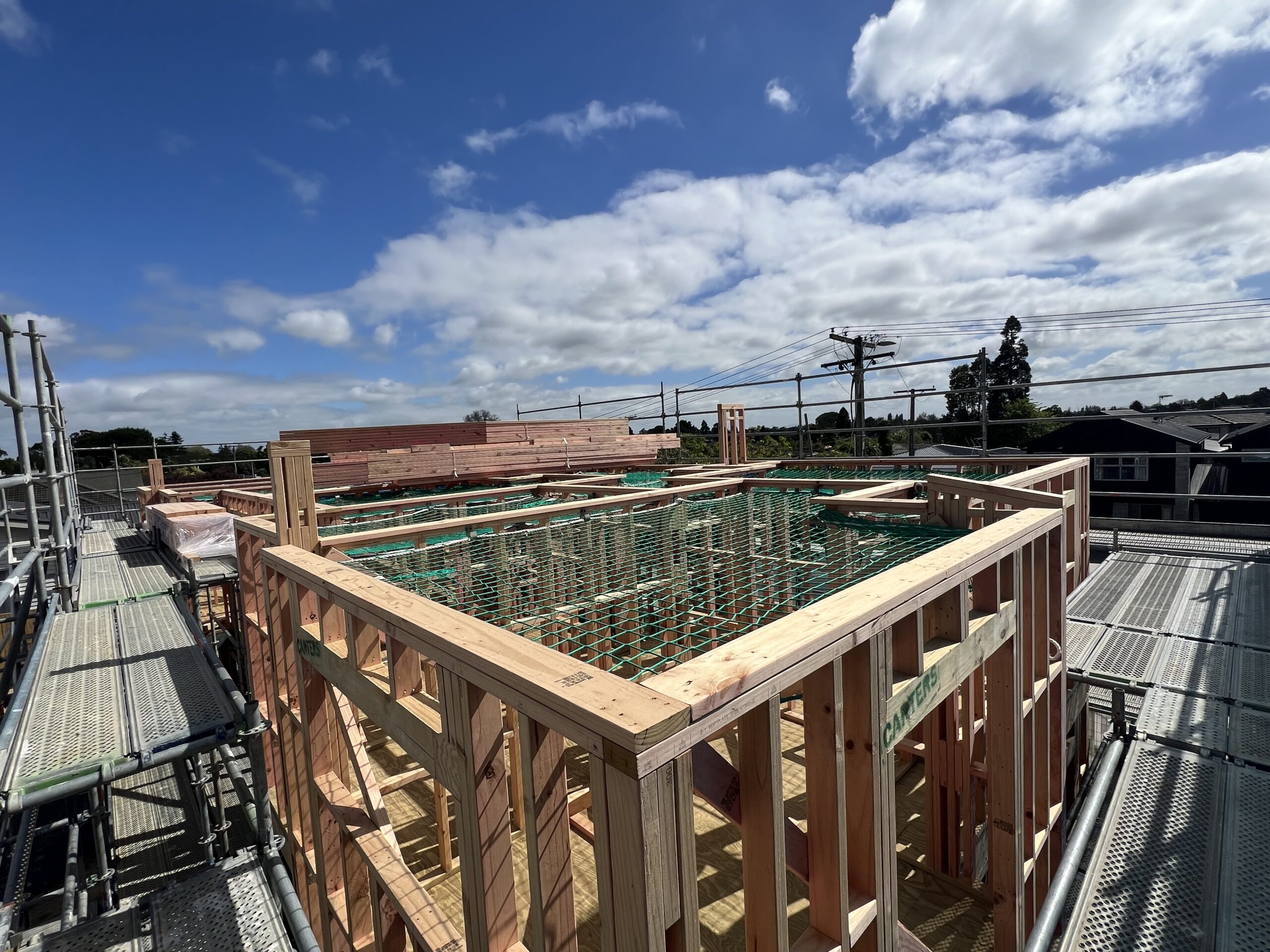

• Complete the concrete pours for Blocks A and B

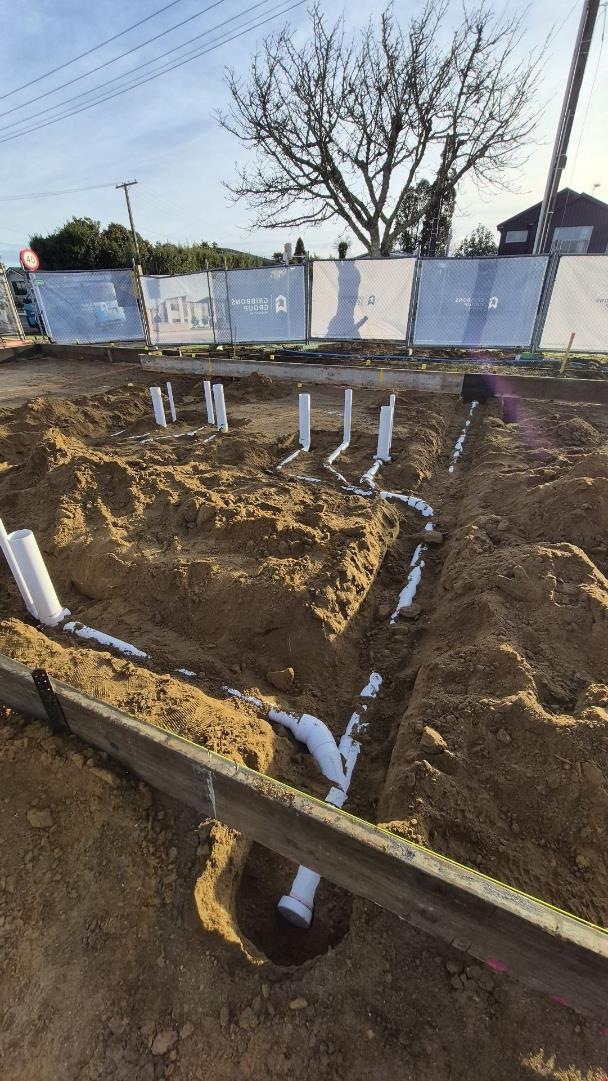

• Progress the remaining drainage works

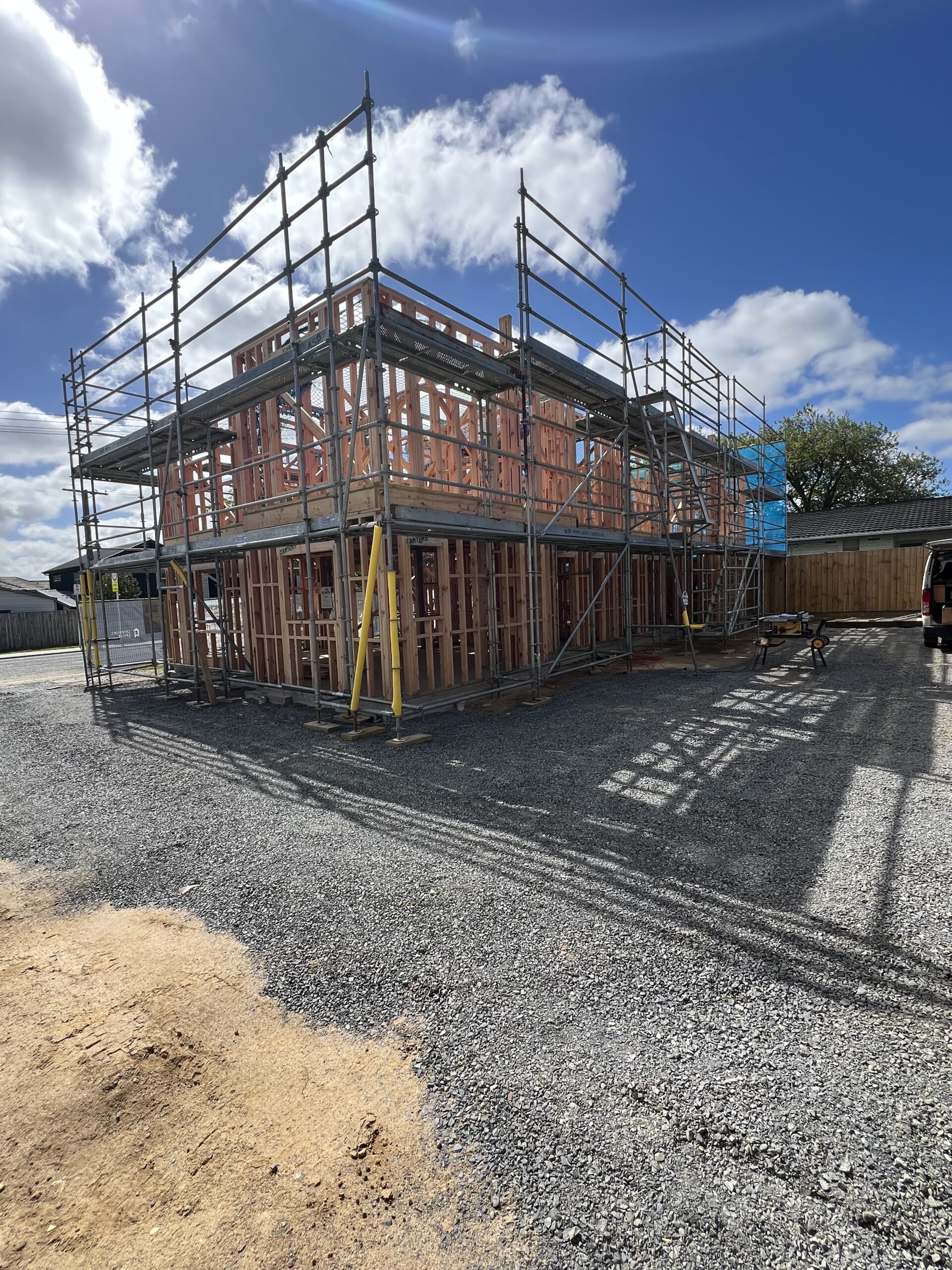

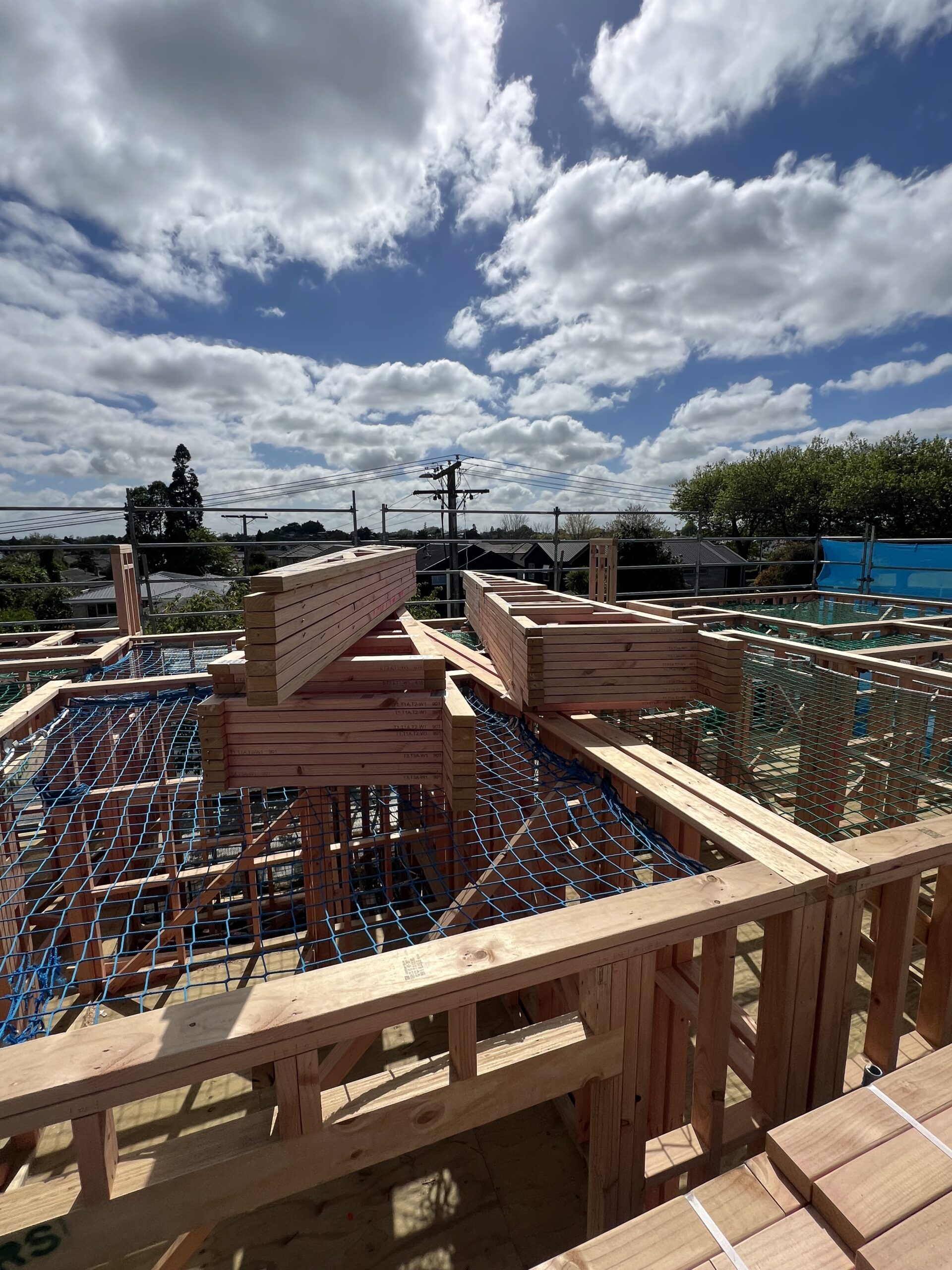

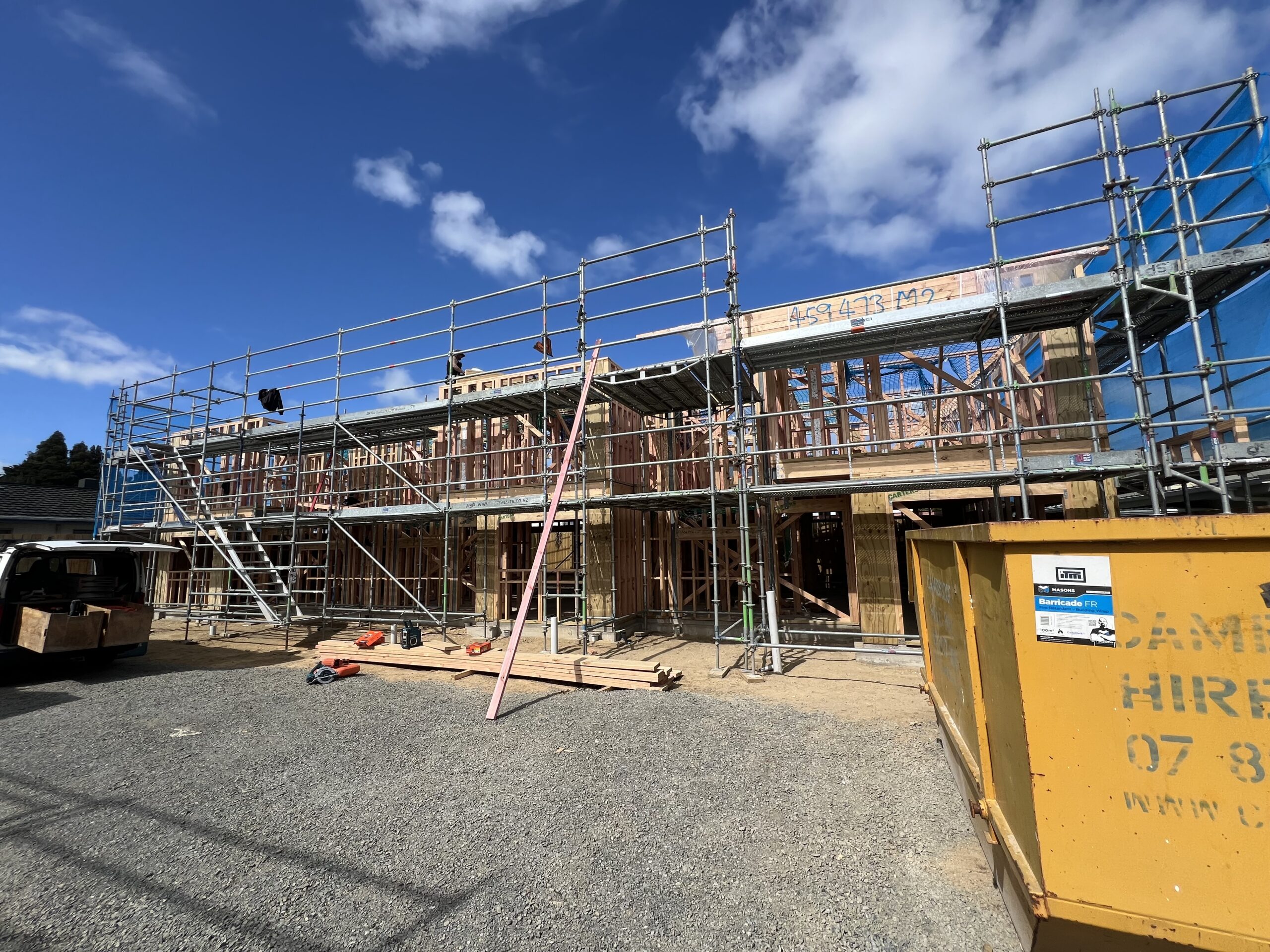

• Deliver and stand the wall frames for both blocks
